Look at a typical GRC calendar and something becomes obvious. Audit fieldwork, evidence requests, exception approvals, vendor onboarding reviews, regulatory change alerts, certification deadlines. Every item on it was placed there by somebody outside the function.

A function whose calendar is entirely externally triggered spends its year responding. The work that would change the organization's risk position, rather than document it, has no slot and no deadline, so it happens when there is room. There is never room.

Response Work Crowds Out Analysis

The externally triggered items share a property that makes them impossible to defer. Each has a counterparty waiting, whether an auditor, a business team blocked on an exception, a procurement process holding for a vendor decision or a regulator with a date.

Self-initiated work has none of that. Nobody chases a risk function for a scenario review, an updated exposure model or a follow-up on systems that were deferred from assessment last cycle. It slips silently and repeatedly, and the annual review concludes that the team needs more headcount when the problem is that the calendar was never designed.

The Split Is Worth Measuring

Categorize a quarter of past work as externally triggered or self-initiated and calculate the proportion. Most functions have never done this and find the answer uncomfortable. It is also the only version of the resourcing conversation that produces a decision, since it distinguishes a team that is under-resourced from one that is fully occupied doing work nobody chose. The pattern connects to how GRC programs break down operationally.

Match Cadence to Rate of Change

The common design assigns most things a monthly or quarterly review because those are convenient meeting intervals. Rate of change varies enormously across what a GRC function watches, so a uniform cadence leaves some items stale and others inspected far more often than anything has changed.

History of successive quantification runs, each with its date, resulting exposure, risk position score and the model version used
A recurring assessment produces a series rather than a snapshot, which is what makes movement between periods readable.

Control state drifts continuously, so anything reviewed monthly has been wrong for up to a month. Vendor populations change whenever procurement completes, which is weekly in most organizations. Framework requirements change on a scale of years. Exception registers grow daily and are reviewed annually in most places, which is the wrong way round given that an expired exception is the item most likely to appear in a finding.

Some Things Should Not Be on a Cadence at All

Several items belong on triggers rather than dates. A new vendor entering a critical process, a system moving from pilot to production, a person with a governance role leaving, or a material change to an existing system. Attaching those to a monthly review means the exposure exists for up to a month before anyone looks, and periodic testing leaves exactly those intervals uncovered.

Reserve Capacity Before It Is Claimed

The practical intervention is unglamorous. Block time for self-initiated work before the externally triggered items arrive, and treat that block with the same protection an audit commitment receives.

Four activities deserve it. Scenario review, since the register ages and entries written two years ago describe an environment that has changed. Exposure re-modeling, which is what converts activity into a position anyone can compare. Follow-up on deferred assessments, because systems repeatedly pushed to the next cycle are usually the ones with no owner and the most exposure. Control effectiveness testing outside an audit completes the set, which is the only way to know whether anything improved between examinations.

Protecting It Requires a Rule

Reserved time survives only if there is an explicit rule about what may claim it. Something like requiring the head of function to approve any displacement, with the displaced work rescheduled rather than dropped, is enough. Without it the block is aspirational and disappears in the first busy month.

A Cadence That Reflects the Work

Grouping by rate of change rather than by convenience produces a different shape.

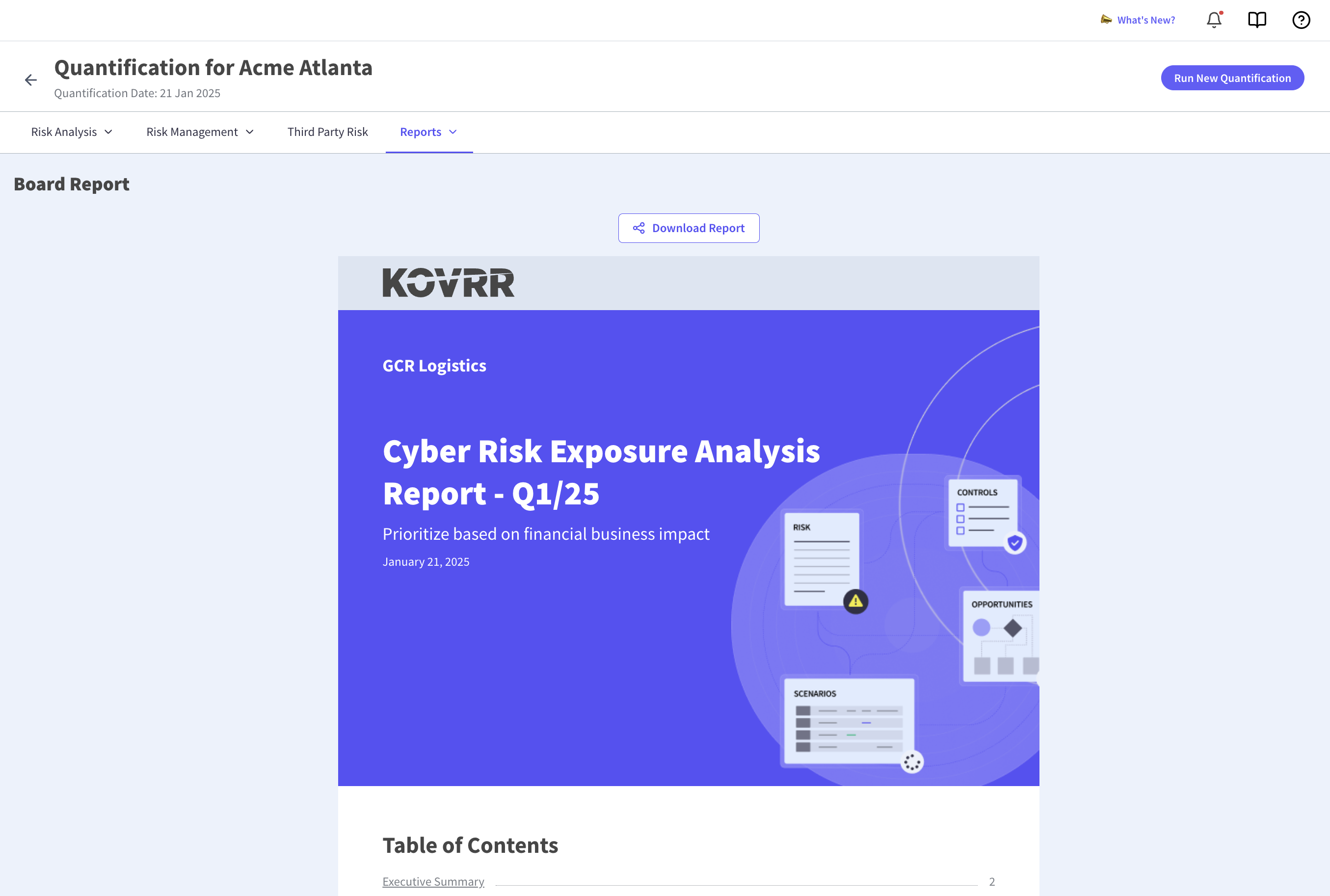

Board report generator producing a quarterly cyber risk exposure analysis with an executive summary, scenarios, controls and opportunities
A reporting artifact produced on a fixed cycle is what gives the rest of the calendar a destination.

Continuous items cover control monitoring output and register intake, both of which are queues rather than meetings. Weekly items cover exception decisions, new vendor triage and remediation progress against agreed dates. Monthly items cover metric aggregation and the reserved analysis block. Quarterly items cover exposure re-modeling, board reporting and access certification. Annual items cover framework reassessment, appetite review and the calendar design itself.

The Annual Item People Forget

Reviewing the calendar is itself an annual item, and it is the one most often absent. Cadences accumulate. A review added after an incident three years ago continues indefinitely because nobody has authority to remove it, and the function ends up meeting about things that stopped mattering. Asking what each recurring item produced this year, and what would happen if it stopped, removes more than it adds.

What Breaks the Calendar

Three disruptions arrive predictably and deserve planning rather than absorption.

  • Audit Season: Evidence gathering consumes the function for weeks, so schedule analysis work outside those windows rather than watching it be displaced.
  • A Significant Incident: Post-incident work is legitimate and unbudgeted, so a standing assumption about how much capacity it claims is more useful than surprise.
  • A New Framework: Arrives with a deadline and no additional resource, and is cheapest to absorb where control mapping already exists.

The third is where preparation pays most. An organization holding a normalized control set maps a new obligation to existing evidence in days, and one holding separate programs per framework runs a fresh assessment. Mapping once and reporting many times is what makes a new requirement a calendar item rather than a project.

What the Cadence Should Produce

A calendar that only generates meetings has failed regardless of how well attended they are. Each recurring item should produce an artifact somebody outside the function uses.

Exception decisions produce a dated record with an expiry. Vendor triage produces a tier and an owner, which tiering across the portfolio depends on. Monthly metrics produce a comparable series rather than a fresh set of numbers. Quarterly modeling produces a figure that can be set against the previous one. The annual framework review produces a statement of what changed and what it cost. Where an item produces nothing durable, it is a status meeting wearing a governance label, and a register built for decisions is where most of these artifacts belong.

Design It Rather Than Inheriting It

Most GRC calendars were assembled from obligations as they arrived, which is why they consist almost entirely of other people's deadlines and why analysis never happens. Matching each item to the rate at which its subject changes, moving event-driven work onto triggers rather than dates, reserving protected capacity for self-initiated analysis and reviewing the calendar itself annually produces a function that occasionally changes the risk position rather than only recording it. Kovrr's cybersecurity GRC approach attaches modeled exposure to register entries, which is what gives the recurring analysis something to compare.

To see what a quarterly exposure figure looks like against your own environment, book a demo with our cyber risk experts.

Shalom Bublil

Kovrr Co-founder & Chief Product Officer

GRC Operating Calendar FAQs

Speak to an Expert

What does a GRC function do week to week?

How should review frequency be decided?

Which GRC work should be trigger-based rather than scheduled?

How do you protect time for analysis work?

What predictably disrupts a GRC calendar?

How do you tell whether a recurring meeting is worth keeping?
